Marketing department uses lean-agile principles to empower employees and get more done.

AUTOMOBILE BODY MANUFACTURING

GREAT DANE INTRODUCTION

Great Dane, with a history dating back to 1900, has established itself as a pioneer in industry and a transportation solutions leader. The visionary VP of Commercial Excellence, Brandie Fuller had clear objectives for her team, but projects took too long to finish. In fact, she was spending week after week in status meetings discussing delays and seeing no real progress. The existing project management process wasn’t working. They had tried and failed to replace this legacy process with agile ways of working. In previous years and she recognized the digital transformation that occurred during the pandemic provided the opportunity to try this method again, with better results. In May of 2022 she reached out to Springbach for help and thus began our 10-month journey.

THE OPPORTUNITY

Brandie initially asked Springbach for agile training to empower employees and work more efficiently. While we were happy to provide some high-level introductory training, we needed a deeper understanding of the problems they were trying to solve. We wanted to train her team on the specific agile practices that would be in the service of solving their problems. We conducted a quick exercise with team members and leadership to foster an open discussion. After some brainstorming, affinity mapping and voting, we gained consensus on the most pressing issues:

  • Projects took too long to finish, or were never completed. The team was busy, often working late and weekends, but there was little to show for their work.

  • Employees were suffering from burn-out; morale was suffering.

  • There was a lack of trust. Escalations were often necessary and expectations were unclear, which fueled a cycle of excess approval-seeking.. This fueled a cycle of excess approval seeking. With a busy leadership team this resulted in lots of delays.

The existing project management practices were not serving this team. We knew there were practices we could implement to break these patterns and replace them with healthier ones. It was time to get started!

HOW MIGHT WE…

Pragmatically inject lean-agile practices to shorten lead times, improve morale, and build trust?

OUR SOLUTION

We provided the requested high-level introductory training with a focus on the key practices that we believed would help this team. Then we developed an approach that would allow Great Dane to experiment, learn, scale and ultimately redefine how they get work done.

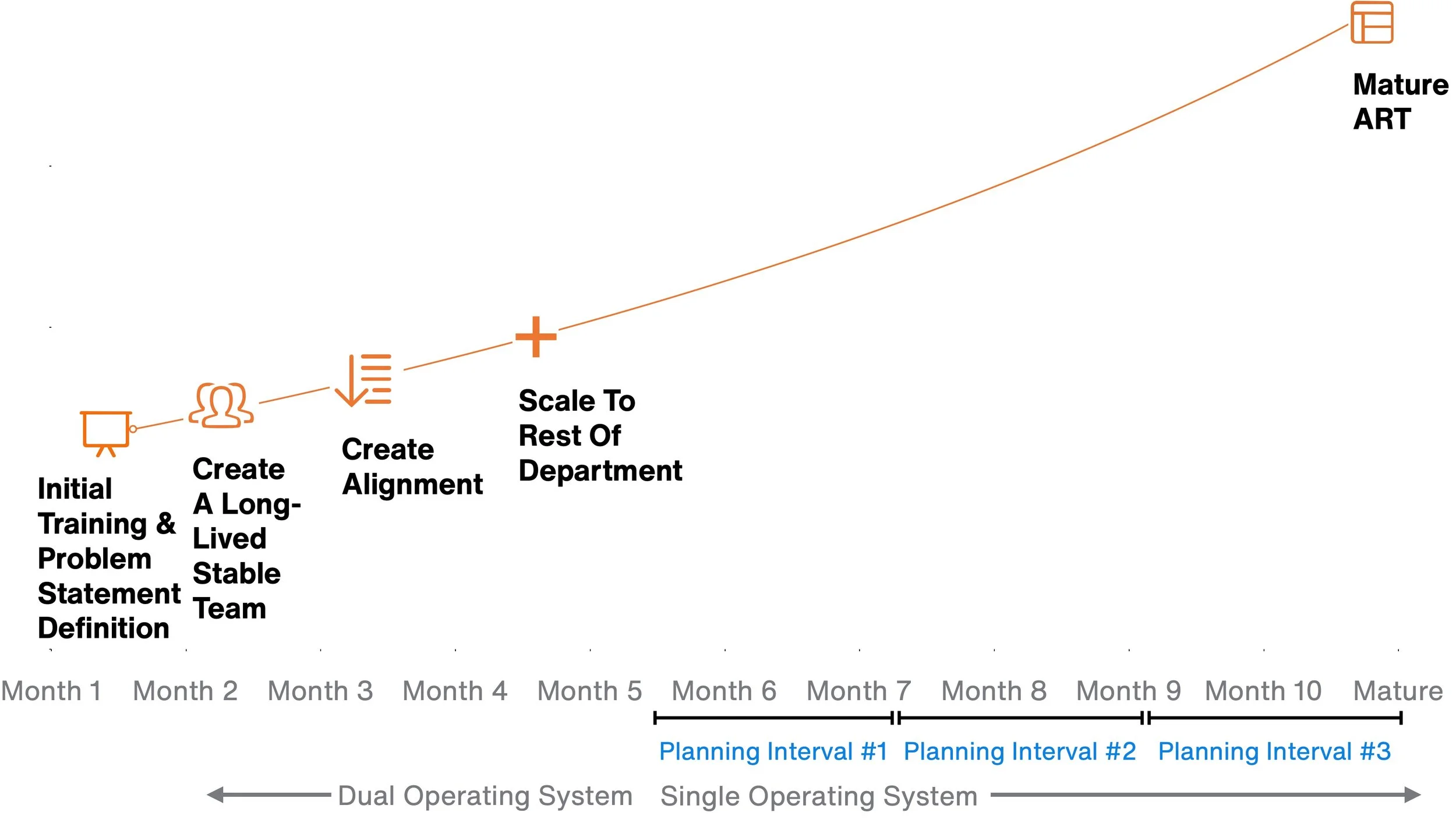

Dive into our process + timeframe

  • Organizing around projects is typically a huge hindrance to flow. Bringing the people to the work (aka the project) causes delays and often requires constant task re-prioritization by management. The first order of business was to establish one, right-sized, cross-functional team that would be long-lived (meaning it would outlive any specific project). Then bring the work to the people instead of the other way around. It sounds subtle, but its hugely impactful.

    Working with leadership we:

    identified a pilot team

    selected Scrum as the methodology

    provided some lightweight training to the team, and

    selected a pilot project to bring to the team.

    Starting with a single pilot team has it advantages:

    You can introduce change slowly. If we had started with everyone all at once, some people may have felt like the change was being pushed on them. With a pilot approach, you can treat it as an invitation and allow people to opt-out if they don’t feel comfortable.

    Allows the team to practice Scrum while executing the project. Its a great place to start when a team is completely new to agile.

    You can validate your decisions and make easy pivots. Is Scrum the right methodology? Is the team composition working? Is it helping to solve the problems we’ve identified? We can validate these decisions early in the process before it impacts too many people.

    You can see key roles in action before making bigger scale decisions. We had to make a key pivot here. Refer to the key learning at the end of this document for why we were glad this was a small mistake.

  • Our pilot team seemed to be set up for success, but we quickly learned that team did not have good guidance on what they were supposed to build. Leadership felt like the ask was clear, but the team was floundering. They were not clear on the context nor did they understand the expectations of leadership. Clearly this is where some of the “approval” mindset was coming from. The team felt like they were running blind and guessing at what leadership wanted and the only way to check their understanding was to constantly go back to leaders with the question” Do you approve?” before moving on the next step.

    This led us to focusing on Feature Refinement almost right away. We asked leadership (the proxy Product Managers at this point) to define and communicate the ask in the form of a well-written Feature that included a description of the problem, a benefit hypothesis and acceptance criteria. This got the team unstuck but, of course, it did not immediately solve the “approval” problem. That would take time and the building of trust but it got us moving in the right direction.

    Having a single team that operates differently from the rest of the organization is not sustainable. After practicing Scrum with our pilot team for 2 iterations we started the feel friction caused by a dual operating model (agile and waterfall). We also started to hear that people not invited to be on the pilot were feeling excluded. We had not solved our problems yet, but the data was telling us we were on the right path and there was overwhelming buy-in to proceed. We were ready to scale to the whole department.

  • Now it was time to expand beyond our single team to include the whole department. To achieve scale, we relied on our experience with SAFe®, the Scaled Agile Framework, and selected essential components to get the results we needed.

    Our first order of business was to get alignment on organizational objectives, define the worked that was needed to deliver on these objectives and create a roadmap. We brought the Business Owners, Product Managers, and Product Owners together for a 2-day roadmapping workshop with the goals of:

    Getting alignment on organizational objectives

    Prioritizing the work, and

    Creating a 6 month roadmap.

    The leadership team at Great Dane really delivered when it came to decomposing the organization’s strategy into right-sized features. They knew exactly what needed to be done, they simply needed some coaching on a few techniques, such as prioritization, feature slicing and acceptance criteria to improve how it would be executed.

    Here’s the team learning and using a prioritization technique called Weighted-Shortest-Job-First (WSJF) to rank its jobs.

    We decided to start with a 8-week Planning Interval (PI), comprised of four, 2-week iterations.

    Then we brought this to the whole team and conducted our first PI Planning event.

    A lot of work went into preparing for this session and creating the plan. I won’t bore you with the details as they are similar to the many Agile Release Train (ART) launches we’ve done in the past. But I will recommend you work with an experienced SAFe® Practice Consultant to get it right.

    We also defined two transformation objectives with Key Results:

    Objective #1: Delivery Predictably

    Benefit Hypothesis: We believe that if we can deliver predictably, then we will create trust, foster empowerment, and improve employee morale. We succeed when our stakeholders receive what we promised when we promised.

    Objective #2: Reduce time spent on maintenance of business (MOB) activities from 90% to 50%

    Benefit Hypothesis: We believe that if we make a concerted effort to measure, document, streamline, and make visible the repetitive MOB work then the Marketing team can spend more of their time adding new value and less time “doing their day jobs”.

    We defined measurable Key Results for each and reviewed them at each iteration and Planning Interval to make sure we stay focused on the problems we were trying to solve.

  • The last step of our approach was to make it sustainable. Brandie had clear objectives and key results for her department which helped create alignment from the very beginning. She also had a clear objective for us: Get the job done and get out. She wasn’t that ruthless about it, but she was clear that she wanted us to develop her team into leaders that could sustain this process on their own. Based on our experience and the capabilities of her team, we set a goal to achieve this at the end of Planning Interval 3. That would give us 24 weeks to anchor these practices into their culture.

    We immediately set about filling key roles and created a 3-point plan to build each leader’s skills and confidence. During the the first PI, the Springbach coaches would lead the events to demonstrate the desired behaviors. During the 2nd PI, our Great Dane counterparts would pair with with us to learn by doing. During the 3rd PI, Great Dane would take the lead while we provided training and coaching.

    Essential to this plan being effective was Great Dane’s leader’s dedication to identifying and nurturing talent. They worked diligently to recognize talent and understand their team member’s career goals to put people in the right roles.

The Results

At the end of the 24 weeks, the Marketing Department achieved real business results. They delivered against 60% of OKRs related to supporting strategic sales unit goals.

Specifically, they delivered key initiatives to supporting becoming the most widely recognized major wreck repair brand and becoming widely recognized as leader in flatbed offerings and availability.

We met all of our transformation objectives

93% ART predictability score

Less time spent on maintenance of business activities

Employee moral improved by 30%

TAKE A PEEK

Our outcomes

  • Outcome:

    By paying attention to our leading indicators, writing SMART PI Objectives and evaluating PI Objective as early as possible within the PI, the Agile Release Train (ART) was able to deliver an ART Predictability Score of 93%. With a target range between 80—100% the ART was delivering predictably, meaning they did what they said there gong to do.

  • Outcome:

    This was particularly important to Great Dane and is common across all business teams and trains we have worked with. They spent as much as 90% of their time performing tasks needed to keep the business smoothly, commonly referred to as “doing their day jobs”.

    But that left only 10% to spend on work that would move the needle. Brandie wanted the team to invest in streamlining and automating as much as they possibly good so that maintenance of business activities took less time and they had more time to spend on value-added work. The team made steady progress against this goal and at the end of Planning Interval 3 the teams have moved the needle from 90/10 (MOB/project) to an almost even split (55/45).

    This is equivalent to technical teams automating their DevOps pipeline and is one of the most important you can do an an organization to achieve more. Its an investment in focus and time but the pay-off is huge and it continues to pay off quarter after quarter.

  • Outcome:

    When you deliver what you say you’re going to deliver and can spend more time on value-added work your satisfaction increases naturally. This sense of accomplishment and being able to work on more creative tasks results in morale scores rising form 2.5 to 3.5 (a significant boost) after only 16 weeks.

“The ‘real work’ and progress that I've experienced through this ART is that all projects are prioritized, watched, and blockers are removed.  In the past, we've had 20 projects to do (per person) so if any of those got blocked, they were addressed, but then put on the back-burner and moved on to the next project waiting for a resolution...Today, each project ‘feature’ is prioritized and blockers are talked about weekly until they are resolved and the project is completed by a team.

There is more of an urgency to remove blockers that keep features from being held up, therefore more projects are completed in a timely manner.”

Jennifer Frady, Product Marketing Manager at Great Dane

What we learned

  • We did our best to identify who we thought had the skills necessary to play the Scrum Master and Product Owner roles on our first team. We got it wrong. Neither person was a good fit and, not-surprisingly, neither person enjoyed the role.

    Fortunately, the team members had the psychological safety to voice their concerns and interests and leadership was not afraid to pivot. It can be hard for teams who have never been exposed to agile to understand these roles without ever seeing them in action. After some first-hand experience, everyone was able to make better-informed decisions before we scaled. Its good to set the expectation that initial roles are just a test.

  • Teams that are really small may put unnecessary stress on Product Owners and Scrum Masters. For our first Planning Interval we had four cross-functional teams of about 3-4 people. This design was meant to allow for growth; however, it did not provide much depth. As a result, the Product Owner also needed to be a part-time team-member.

    The Product Owner role was new to almost all of them and the pressure of learning of new role while still trying to meet team commitments just wasn’t necessary. For Planning Interval #2, we combined to just two (still right-sized) teams where the Product Owner could be dedicated to the role. In the future, I would discourage trying to split the PO role unless they are coming in with considerable experience.

  • You can read our blog post here [write post and add link] for more details. These OKRs were our “north star” and kept us accountable to solving the problems we set out to solve.

  • Sustaining new practices takes discipline. One of the key roles in providing that discipline is the RTE. All clients want to be able to sustain any process that is working without reliance in outside consultant. And Great Dane may be in the best position of all to do so because we found the right person to play the RTE, Taylor Giem. She is a quick learner, dedicated and disciplined. She exhibits a dedication to the craft and willingness to continuously learn and lead. All skills I would look for in a a potential RTE.

  • Of course! We knew this would happen. But you have to start somewhere! This ART is predictably delivering value but its just one functional in a much larger system. Marketing has dependencies with Sales, Human Resources, Engineering, IT and digital teams. It only took three PIs to hear from from the Executive Vice President of Sales, that the ART was producing more content and collateral than the sales team could absorb. That’s a bottleneck. But for us, that’s a good problem to have we know where to go next.
